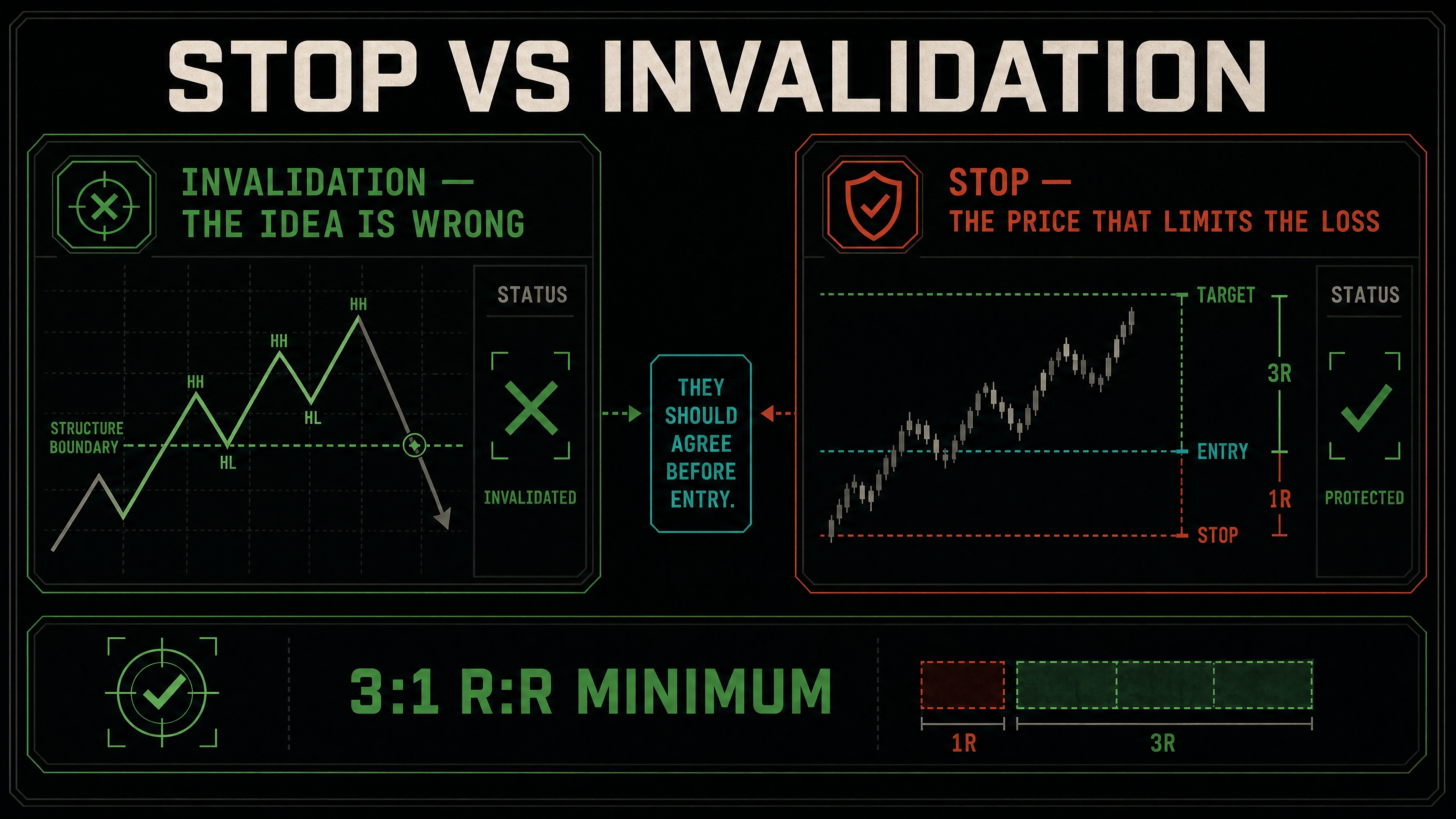

#

Follow the risk hierarchy

Choose size last. The stop comes from the structure, and the loss limit comes from your independently chosen risk policy.

  1. 01
    Thesis

    State what must remain true for the trade or investment to exist.

  2. 02
    Invalidation

    Name the observable evidence that proves the thesis wrong.

  3. 03
    Stop

    Place the exit beyond invalidation with realistic room for execution.

  4. 04
    Unit risk

    Calculate the currency loss for one share, contract, or spread at that stop.

  5. 05
    Size

    Divide the maximum planned loss by unit risk and round down to a valid quantity.

  6. 06
    Portfolio heat

    Add correlated open risk before approving any new position.

Visual Academy C06 · Stop and InvalidationAccepted internal asset · Source preserved
#

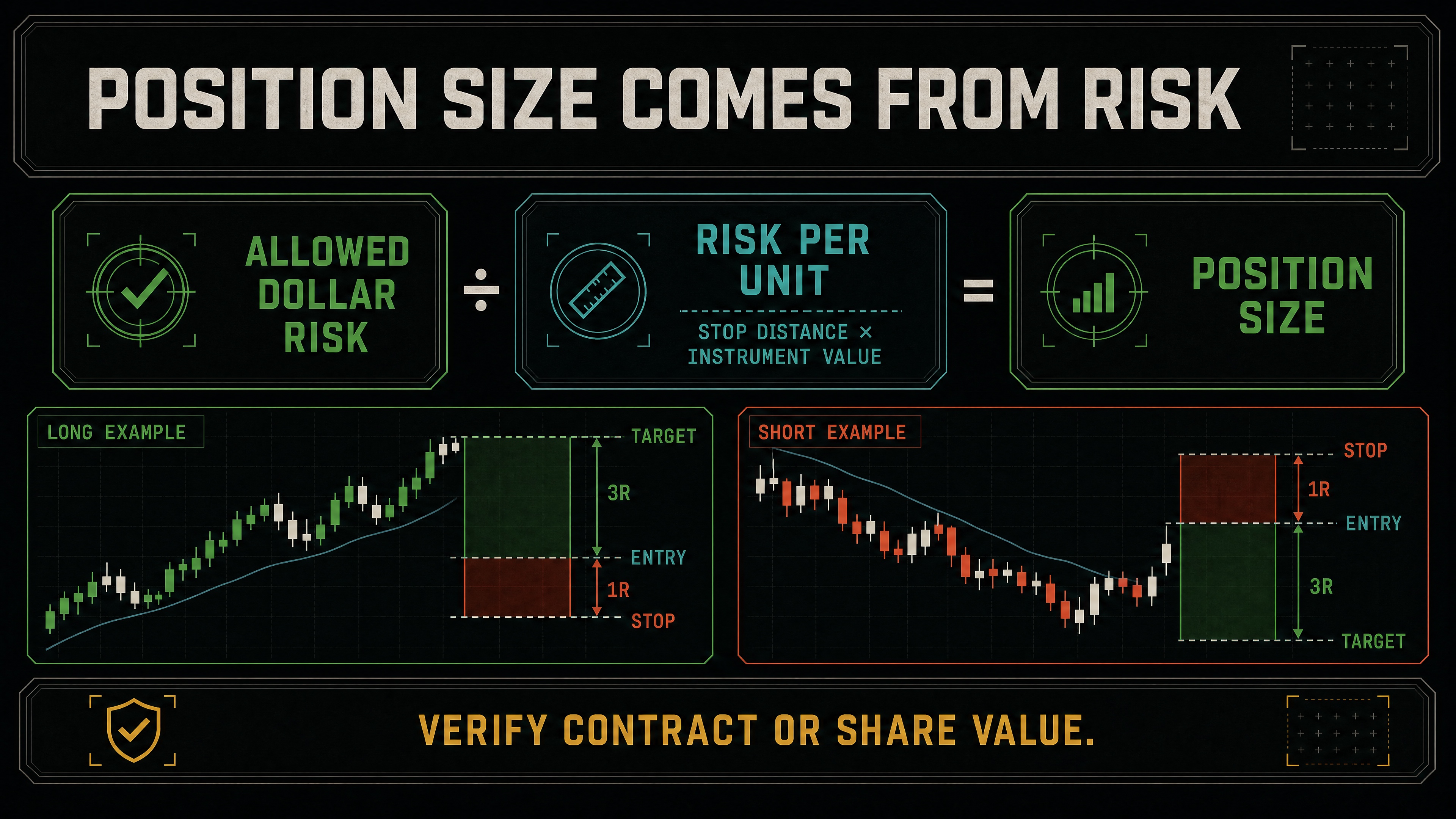

Calculate position size from the stop

The generic formula works only when the instrument value, contract multiplier, fees, slippage, and gap risk are represented correctly.

Position-size worksheet
Maximum planned loss = independently chosen risk limit
Stop distance = absolute value of entry − stop
Unit risk = stop distance × instrument point value
Raw quantity = maximum planned loss ÷ unit risk
Final quantity = round down, then recheck fees, slippage, gaps, and liquidity
Visual Academy C07 · Position SizeAccepted internal asset · Source preserved
#

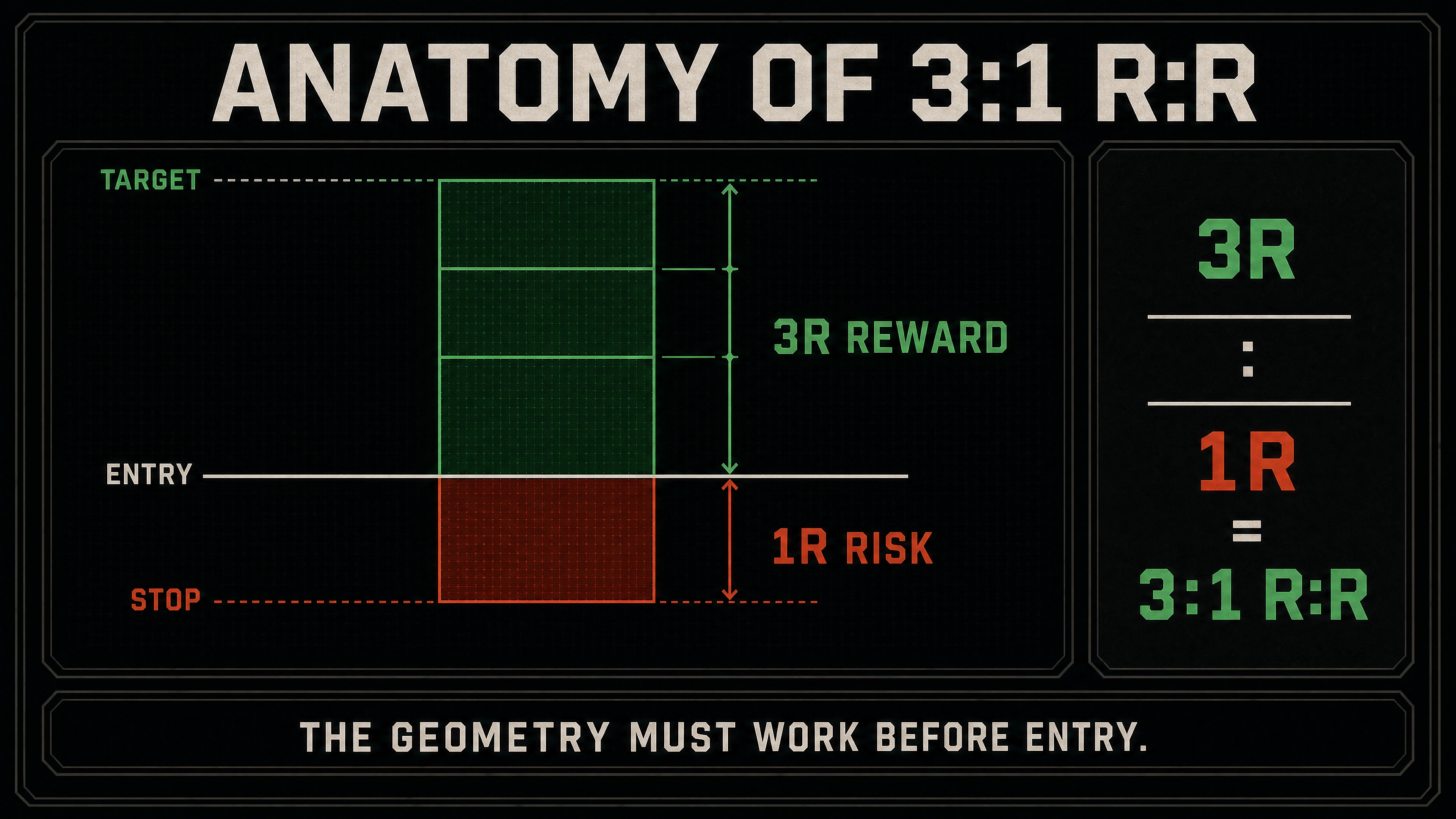

Understand the 3:1 gate

Three-to-one means the planned reward is three times the planned loss. It is a screening gate, not a forecast that the target will trade.

Visual Academy C02 · Three-to-OneAccepted internal asset · Source preserved
Win rateAverage winAverage lossExpectancy before costs
25%+3R−1R0R break-even
30%+3R−1R+0.20R per trade
40%+3R−1R+0.60R per trade
50%+3R−1R+1.00R per trade
#

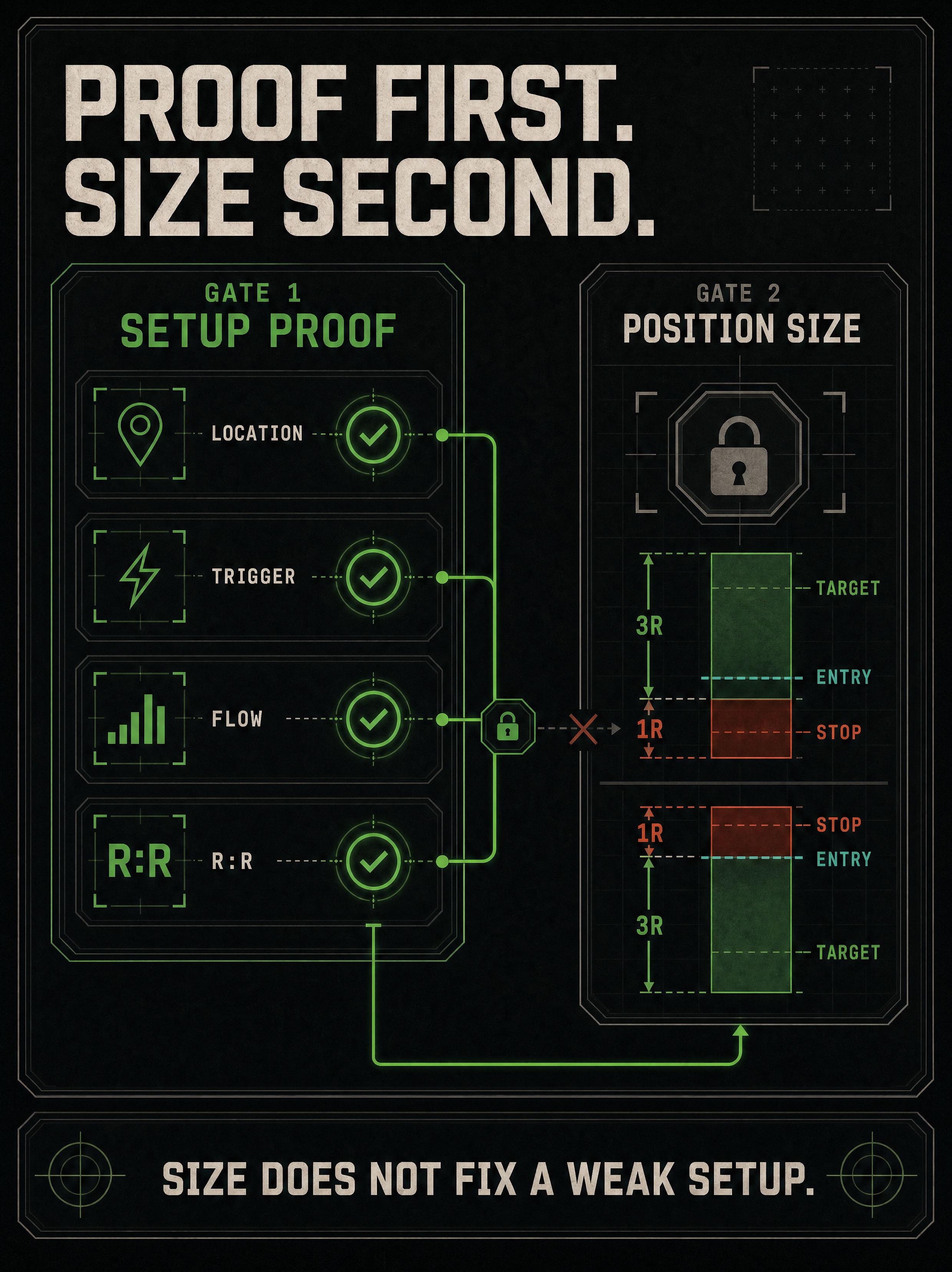

Measure combined and correlated risk

Five positions can be one trade wearing five ticker symbols. Add open risk by theme, direction, asset, and catalyst before you call the book diversified.

  • Add the loss at each current stop across all open positions.

  • Group positions that depend on the same index, sector, factor, commodity, crypto asset, or event.

  • Stress gaps and volatility expansion instead of assuming every stop fills at the planned price.

  • Include options delta, leverage, and nonlinear exposure when the payoff is not share-like.

  • Reduce new size when one thesis already dominates the portfolio.

Visual Academy C05 · Proof Before SizeAccepted internal asset · Source preserved
#

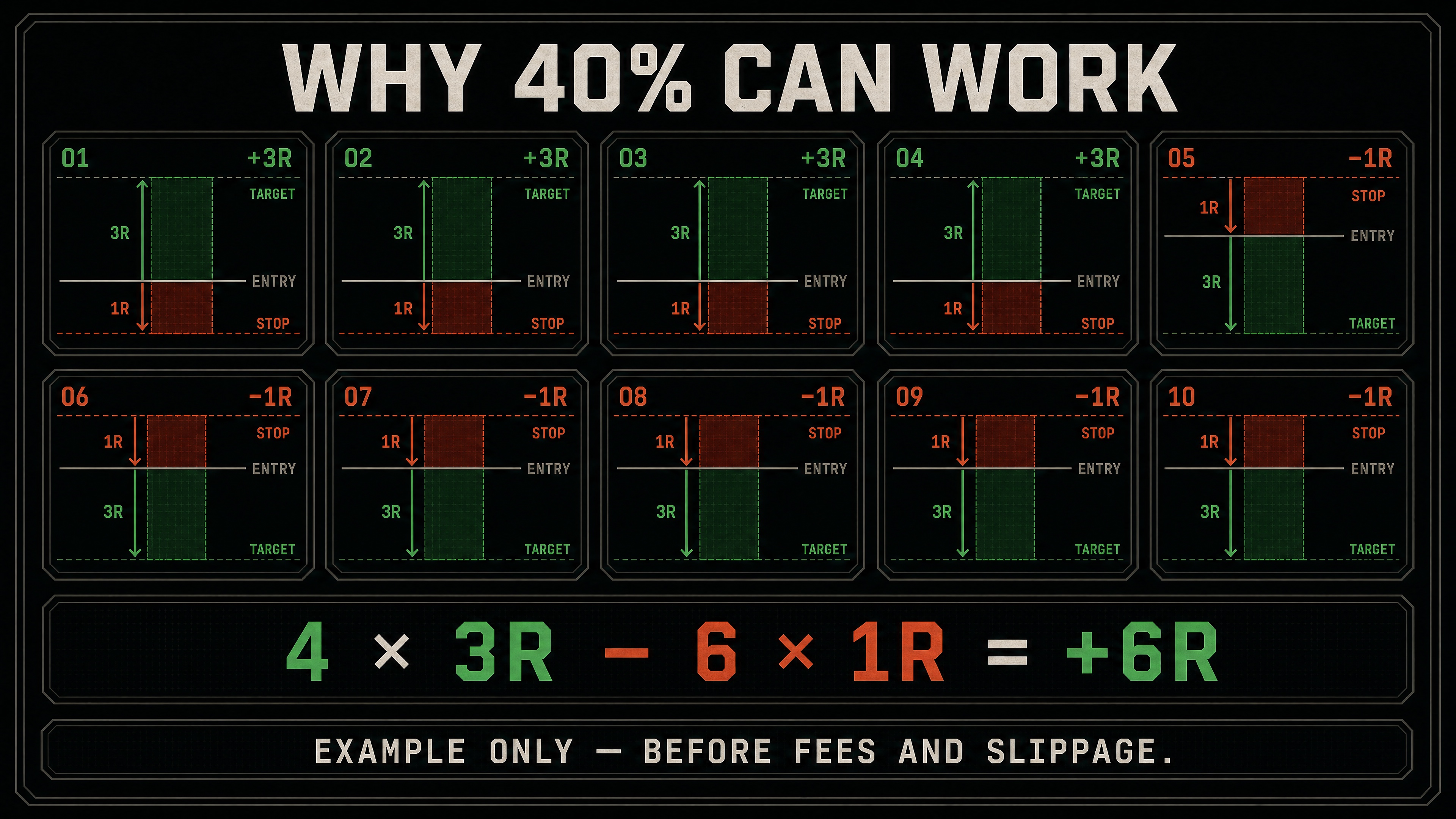

Install drawdown circuit breakers

A drawdown plan written while calm is more useful than a promise made after the account is already under pressure.

Loss from peakGain needed to recoverProcess response
10%11.1%Review execution and reduce uncertainty before adding risk
20%25%Cut exposure, test whether the regime or edge changed, and narrow the playbook
30%42.9%Pause discretionary expansion and complete a formal system review
40%66.7%Capital preservation dominates recovery attempts
50%100%The recovery burden has doubled the required capital growth
Visual Academy C04 · Drawdown Recovery MathAccepted internal asset · Source preserved
#

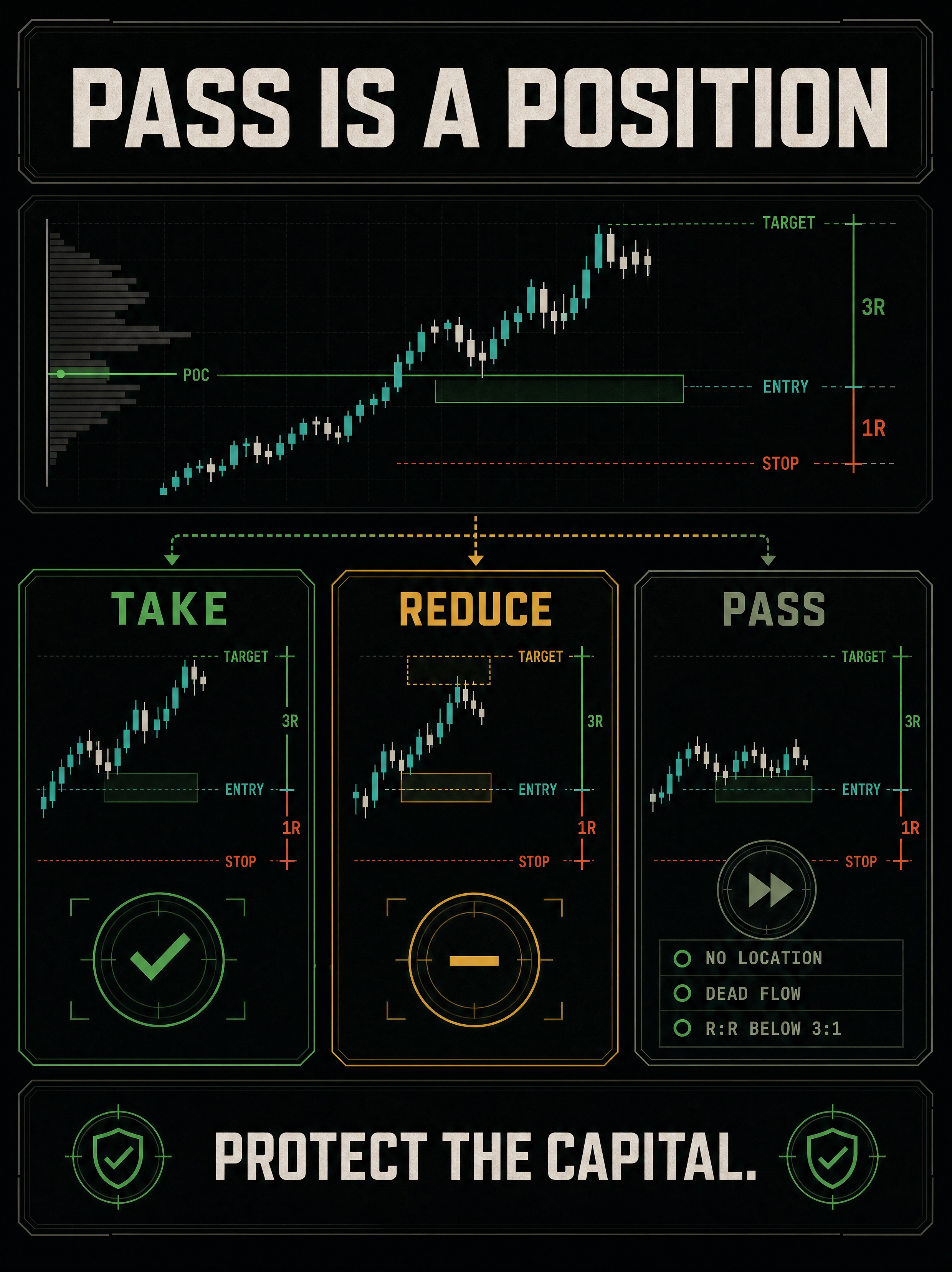

Treat passing as a position

You do not owe the market a trade. Cash, observation, and smaller exposure are valid decisions when the evidence or risk is incomplete.

Visual Academy C08 · Pass Is a PositionAccepted internal asset · Source preserved
